Construction of 120 Nos. GPRA Type-VII Flats

Pocket-1, DDU Marg, New Delhi

Project Name : Construction of 120 Nos. GPRA Type-VII Flats

Date of start of work is 09.09.2018 with duration 21 months. Work will commence through monolithic construction technology using aluminium formwork.


197.33 Cr (A/A & E/S) Lakh

Project Budget


09 Sep 2018

Start Date


06 Aug 2020

Completion Date


New Delhi

Location

Project Team / Contact Us

S.No. Name(Mr/Mrs) Designation Office Address Office Number Mobile Number Email ID
1 Sh. Tarkeshwar Tiwary Project Manager, Development Project Circle B-314, I.P. Bhawan, New Delhi. delpmdpc.cpwd@gov.in
1 Sh. Tej Kumar Nagarwal Executive Engineer, Development Project Division-I B-312, I.P. Bhawan, New Delhi dpdcpwd.ee@gmail.com
1 Sh. Sanjiv Kumar Assisrtant Engineer B-312, I.P. Bhawan, New Delhi sanjivkumar.cpwd@gmail.com

Highlights

S.No. Description Images

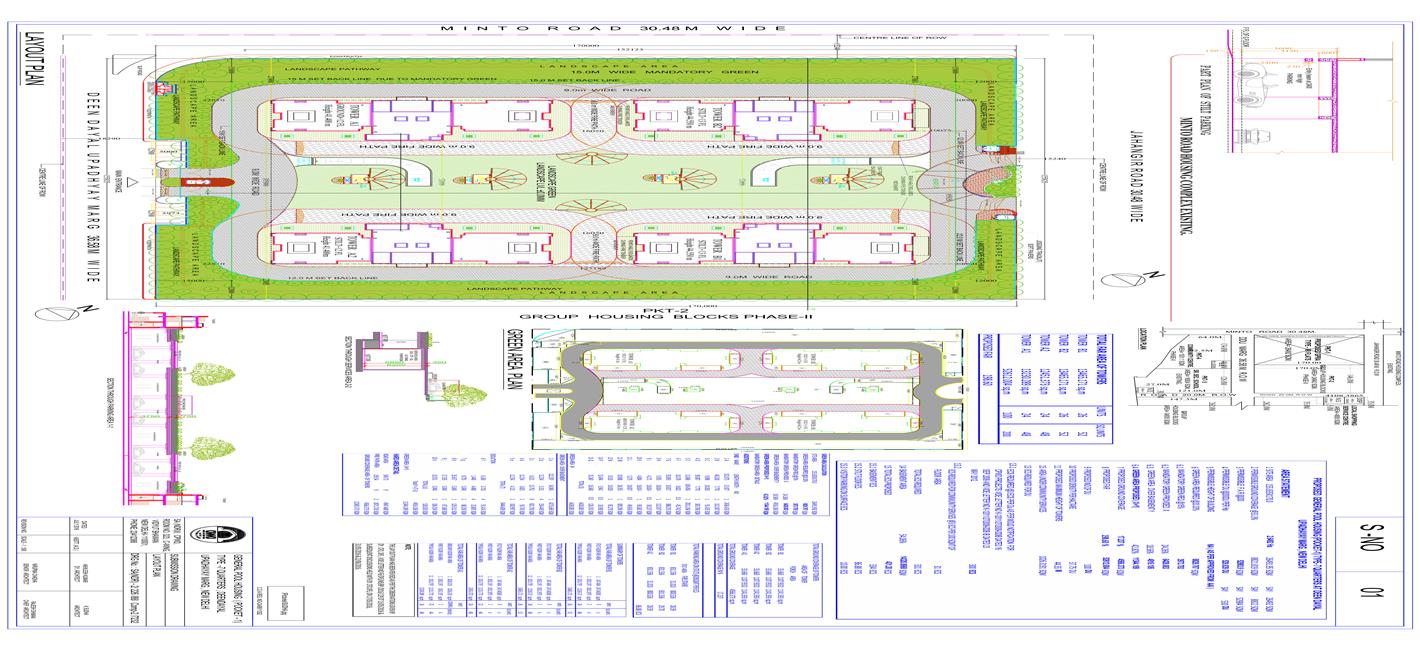

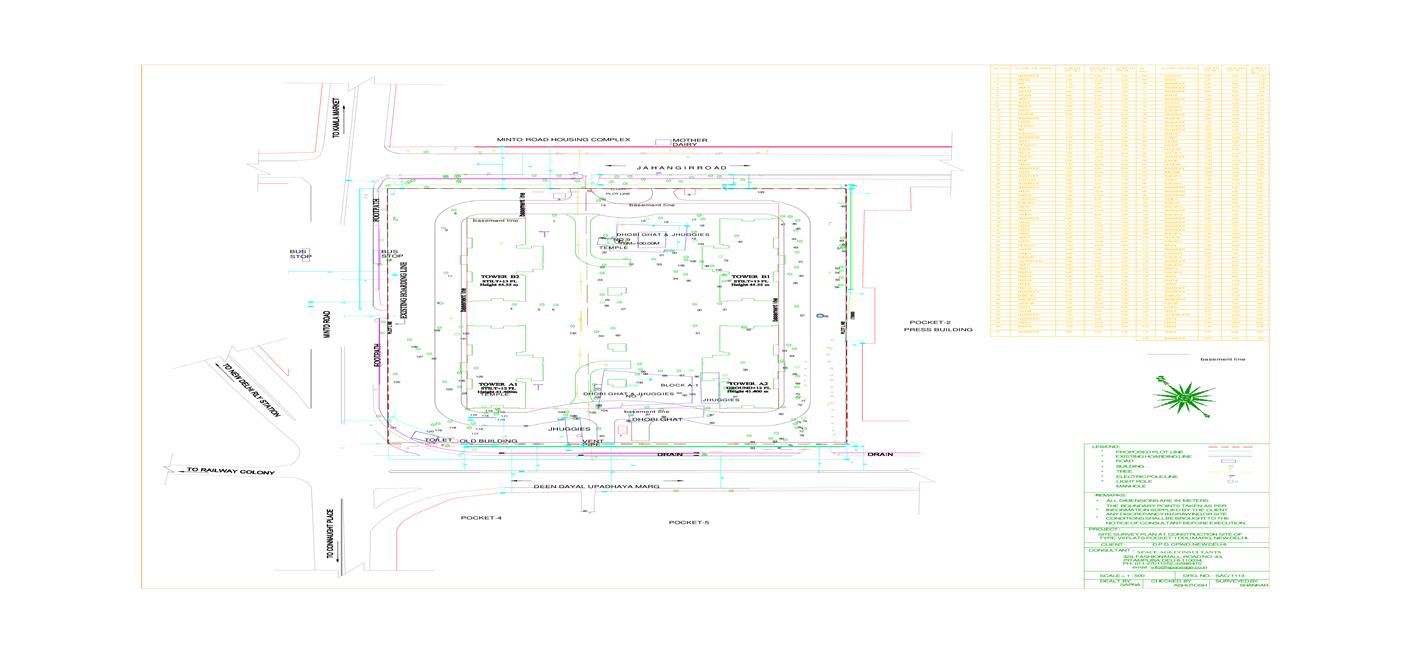

1

Administrative Approval & Expenditure Sanction: 197.33 Cr.

Project Construction Cost: 175.0 Cr.

Agency: M/s Vijay Nirman Company Pvt. Ltd.

Date of Start: 09.09.2018

Duration: 21 Months



Date of Completion: 08.06.2020

PROJECT BRIEF

Plot Area: 26,492 Sqm (6.6 Acre)

Built up area: 88783 Sqm

No. of Basement: 01

NEW CONSTRUCTION TECHNOLOGY ADOPTED:

Monolithic Construction Technology using Aluminium Formwork with Self Compacting Concrete.

SALIENT FEATURES:

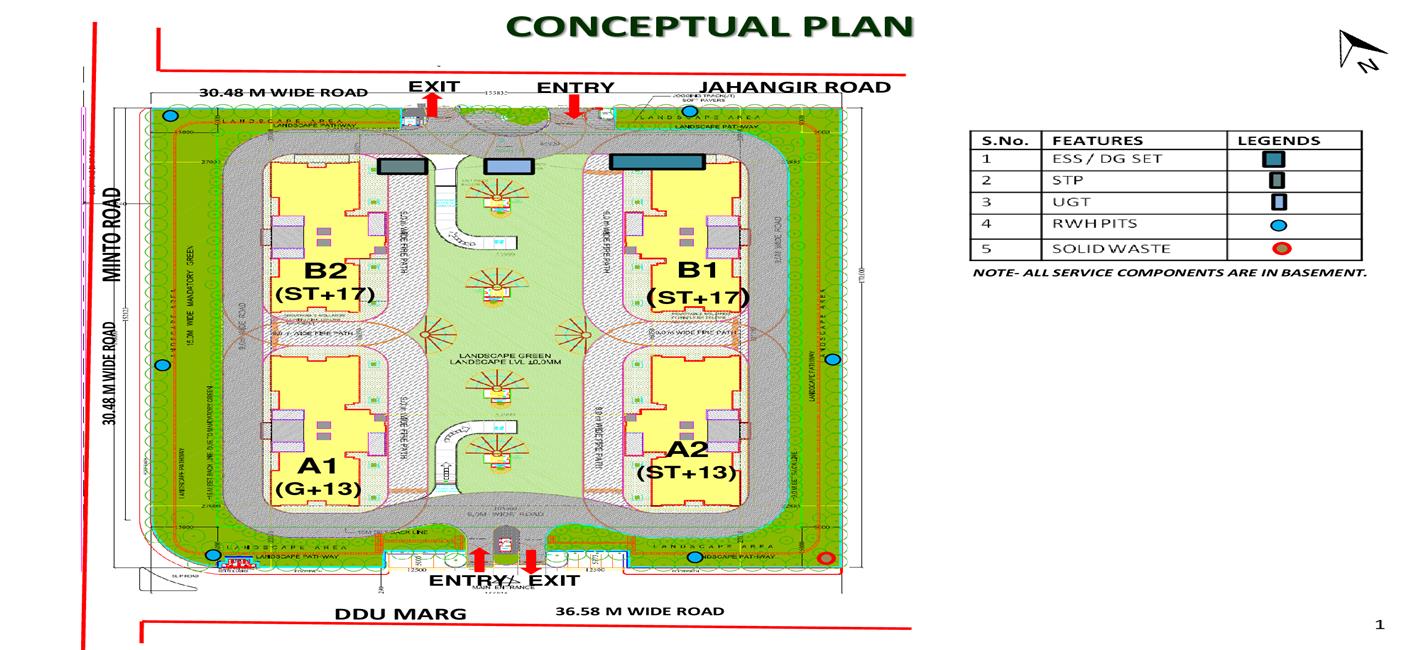

  • Project comprises total 04 Towers with basement. 02 Towers are stilt + 13 storey and 02 Towers are stilt + 17 storey.
  • Area of one unit is 358 sqm. There are two flats at each floor with servant unit.
  • In tower A1 provision of Club, Gym, Shop & Service Center is there.
  • Central Intercom System
  • Silent type DG sets 625 KVA
  • 8 Nos. 16 passenger and 4 nos. fireman/Goods lift.
  • CCTV and Access Control System

GREEN FEATURES:

  • Roof Top Solar Power Generation
  • Solar water heating system
  • Energy saving LED fitting
  • STP for recycling of waste water & its reuse
  • Rain water harvesting
  • Solid waste management
  • Low water consumption plumbing fixtures
  • Use of low VOC paint





.

Implementation Strategy

S.No. Description Images

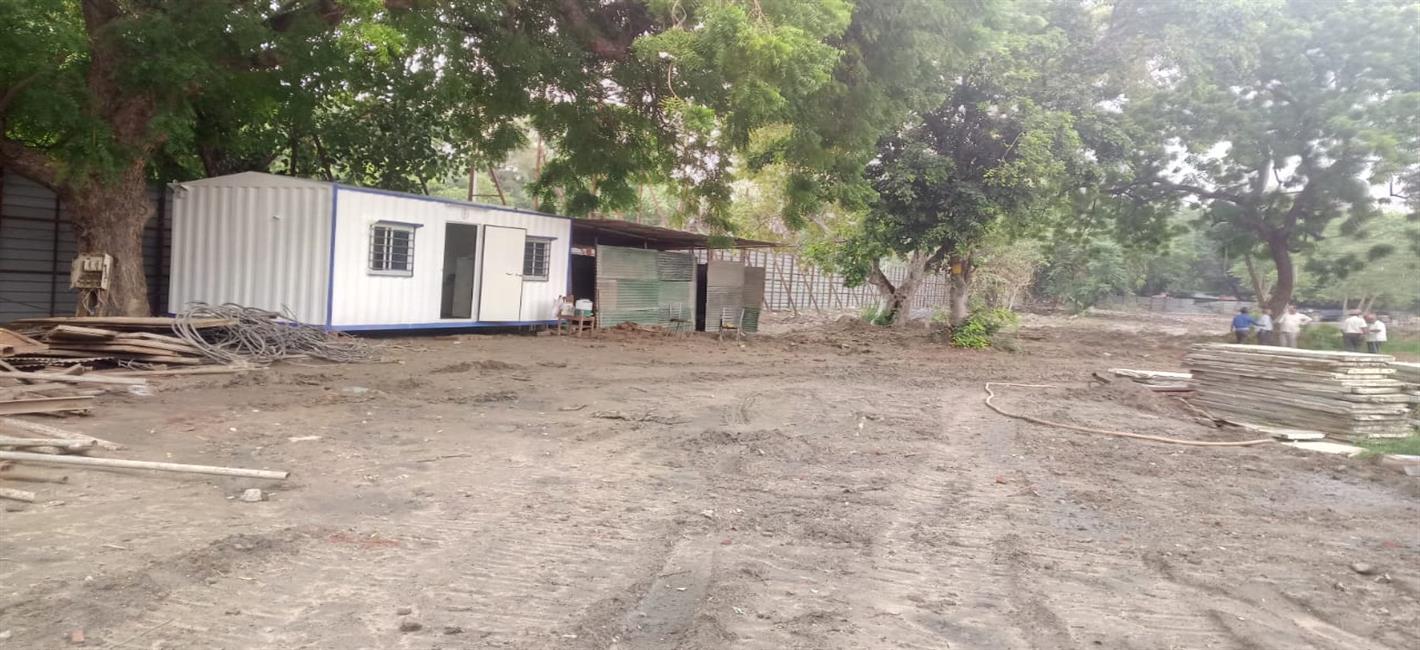

1
  • Presently construction of two towers A1 & B2 has been taken up for execution. Remaining two towers A2 & B1 and non
    tower area will be taken up after shifting of existing Jhuggi Jhopri Cluster (54 No).
  • Structure part will be completed within 16 months.

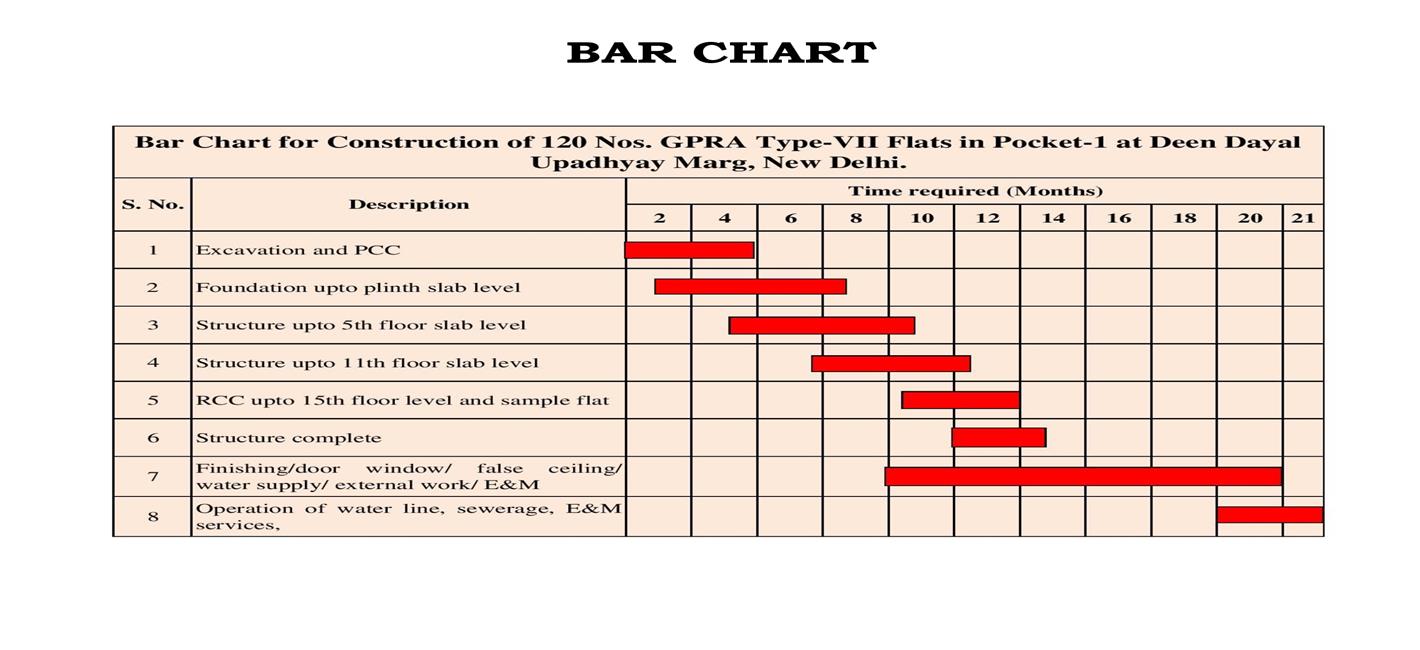

  • By using Aluminium formwork it is planned that one storey will be constructed in 10 days.



Lessons Learnt / Take Aways

S.No. Description Images
1

Work started at site. Duration of project 21 Months.

2

Work has started on 09.09.2018 and after completion of work lesson learnt detail would  be elaborated.
