Construction of Boys Hostel at MNNIT Allahabad (U.P.) on EPC basis.

MNNIT Allahabad

Project Name : Construction of Boys Hostel at MNNIT Allahabad (U.P.) on EPC basis

Innovative Technology


6836.69 Lakh

Project Budget


23 Feb 2018

Start Date


22 Oct 2019

Completion Date


Allahabad

Location

Project Team / Contact Us

S.No. Name(Mr/Mrs) Designation Office Address Office Number Mobile Number Email ID
1 Ravindra Yadav Superintending Engineer Kendriya Sadan First Floor 34A MG marg civil lines Allahabad 211001 secalld@gmail.com
0 Ravindra Yadav Executive Engineer Allahabad Project Division MNNIT Campus Allahabad 211004 eeapdcpwd@gmail.com
1 Chandan Singh Assistant Executive Engineer Allahabad Project Division MNNIT Campus Allahabad 211004 aeeapdcpwd@gmail.com
1 Anand Kumar Assistant Engineer Allahabad Project Division MNNIT Campus Allahabad 211004 akaecpwd@gmail.com
1 Shailendra kumar Yadav Assistant Engineer Allahabad Project Division MNNIT Campus Allahabad 211004

Highlights

S.No. Description Images
1



                                            Salient features



1. Name of work:- Construction of Boys hostel at MNNIT Allahabad(U.P.) on EPC basis.



2. Agency:- M/s C.K. Construction.



3. Date of start:- 23/02/2018



4. Date of completion:- 22/10/2019



5. Time of completion:- 20 months(4 months for planning & 16 months for execution)



6. Estimated cost:- Rs 633672976



7. Tendered amount:- Rs 683669774



8. Three blocks of G+13 story each and a kitchenblock of G+1 story.



9. Percentage Progress:-18.0%



10. Physical Progress 18 %,

1.  Building consiss of 03 Blocks of G+13 floors namely Block-A,B & C. RCC upto 13th floor using monolithic construction technology for        Block-B completed. RCC work for Block-C is targeted to be completed by January 2020 & Block-A by April 2020.

2. Finishing activities like AAC Block work, plumbing, IEI, wood work, stone work, tiling, painting etc is in progress in Block-B and targeted to completed by December 2019 & finishing work of Block-C is targeted to be completed by March 2020 & Block- A by June 2020.

2

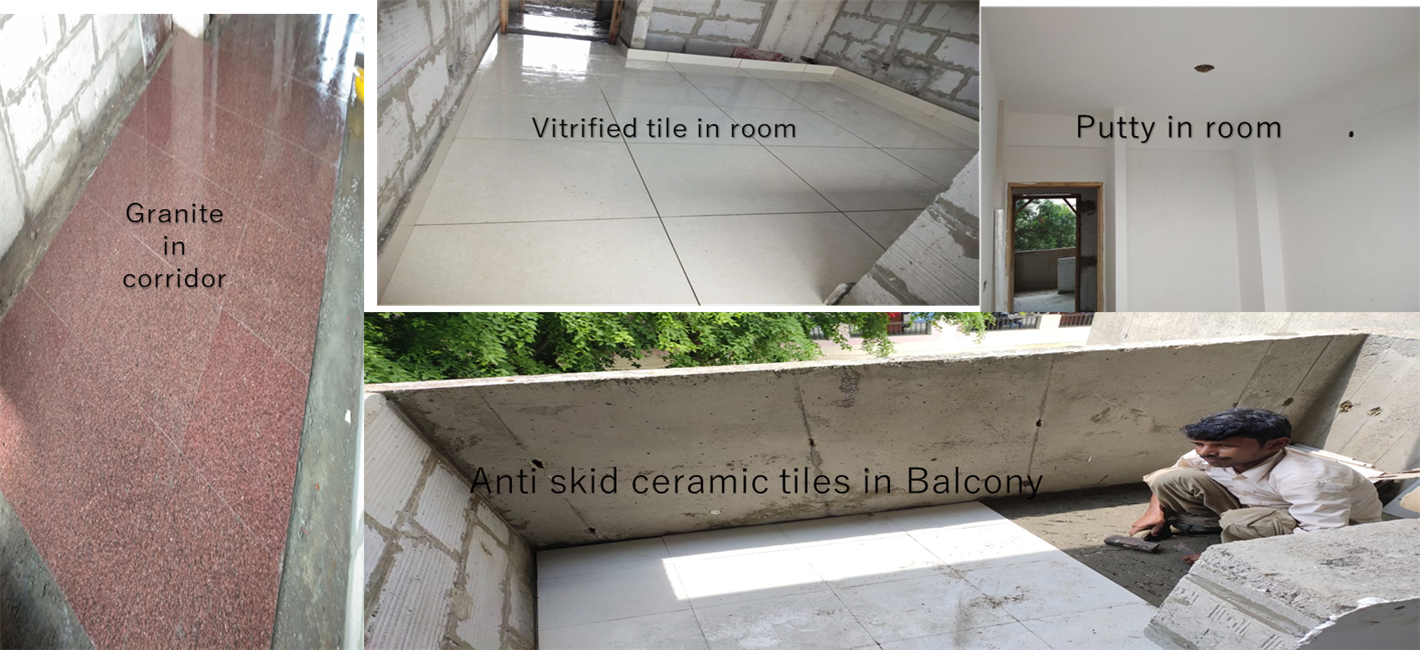

Laying of Granite in corridors, vitrified tiles and putty in rooms and anti-skid ceramic tiles in balcony in progress.

3 Laying of Granite in corridors, vitrified tiles and putty in rooms and anti-skid ceramic tiles in balcony in progress.

Implementation Strategy

S.No. Description Images
1

1. Setting up the wall Reinforcement steel – The wall reinforcing with steel is used to give a structure to the building and support the concrete until they gain the required strength. The aluminum formworks are cast around the steel mesh, which is factory made as per architectural drawings and directly erected on the construction site.


2. Placement of Aluminum formwork – Along the wall reinforcing steel, prefabricated room sized walls and floor slabs are erected. These aluminum alloy slabs are accurately made and are easy to handle. Spaces for windows, ducts, doors and other features such as staircases, façade panels, Lofts slabs (Kitchen counter slab with supporting walls) and chajjas are also integrated in these structures. The forms are joint together using the pin and wedge system, which can be dismantled quickly after the concrete structure is made for vertical surfaces and even for horizontal surface with immediately propping systems.


3.Pouring of concrete – After setting up the aluminium formwork, high-quality concrete is poured such as SCC type concrete with good and acceptable flow rates specially designed with rich mix. This concrete takes the form and shape of the forms and reaches the buttom and corners,  forms later removed to make way for a structure made entirely of cement concrete supported by wall reinforcing members.


4. The resulting structure is accurate, smooth and finished. It has high tolerance and requires no further plastering. Thereby saving time, effort and money.

Lessons Learnt / Take Aways
